Bunnings Truck Loading Dock Stabilisation

Case Study

Location: Bunnings, Windsor Gardens SA

Project Type: Stabilisation

Project Team: Urathane Solutions, South Australia

Bunnings Truck Loading Dock Stabilisation

Project Overview

This project involved a 47m² driveway slab servicing a high-traffic truck loading dock. The slab had settled due to unengineered fill and inadequate compaction, compounded by constant heavy vehicle loading.

Temporary steel ramping had been installed to maintain usability; however, a long-term solution was required to restore structural performance and eliminate ongoing deterioration.

Key Challenges

  • Poorly compacted and unengineered fill material
  • Continuous heavy truck loading accelerating settlement
  • Critical operational area with minimal downtime allowed
  • Location above an active car park requiring controlled injection
  • Need for immediate usability post-works

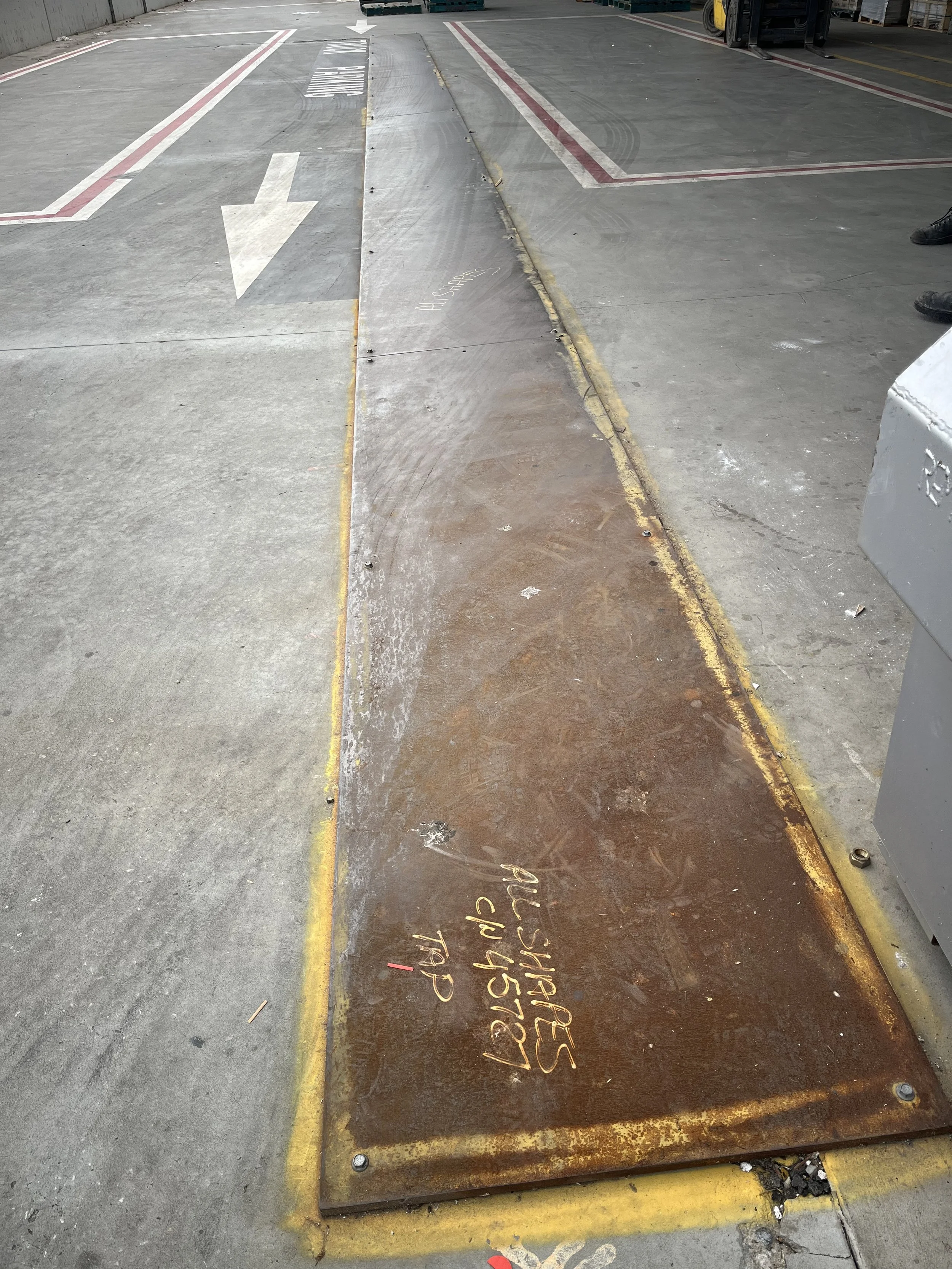

Temporary steel ramping installed to maintain usability prior to Urathane’s works

Scope of Works

Urathane Solutions delivered a targeted stabilisation program, including:

  • Resin injection across 47m² slab area
  • 95 injection points installed at ~1m depth
  • Ground densification and void filling beneath slab
  • Controlled slab lift to restore levels
  • Injection carried out under load conditions

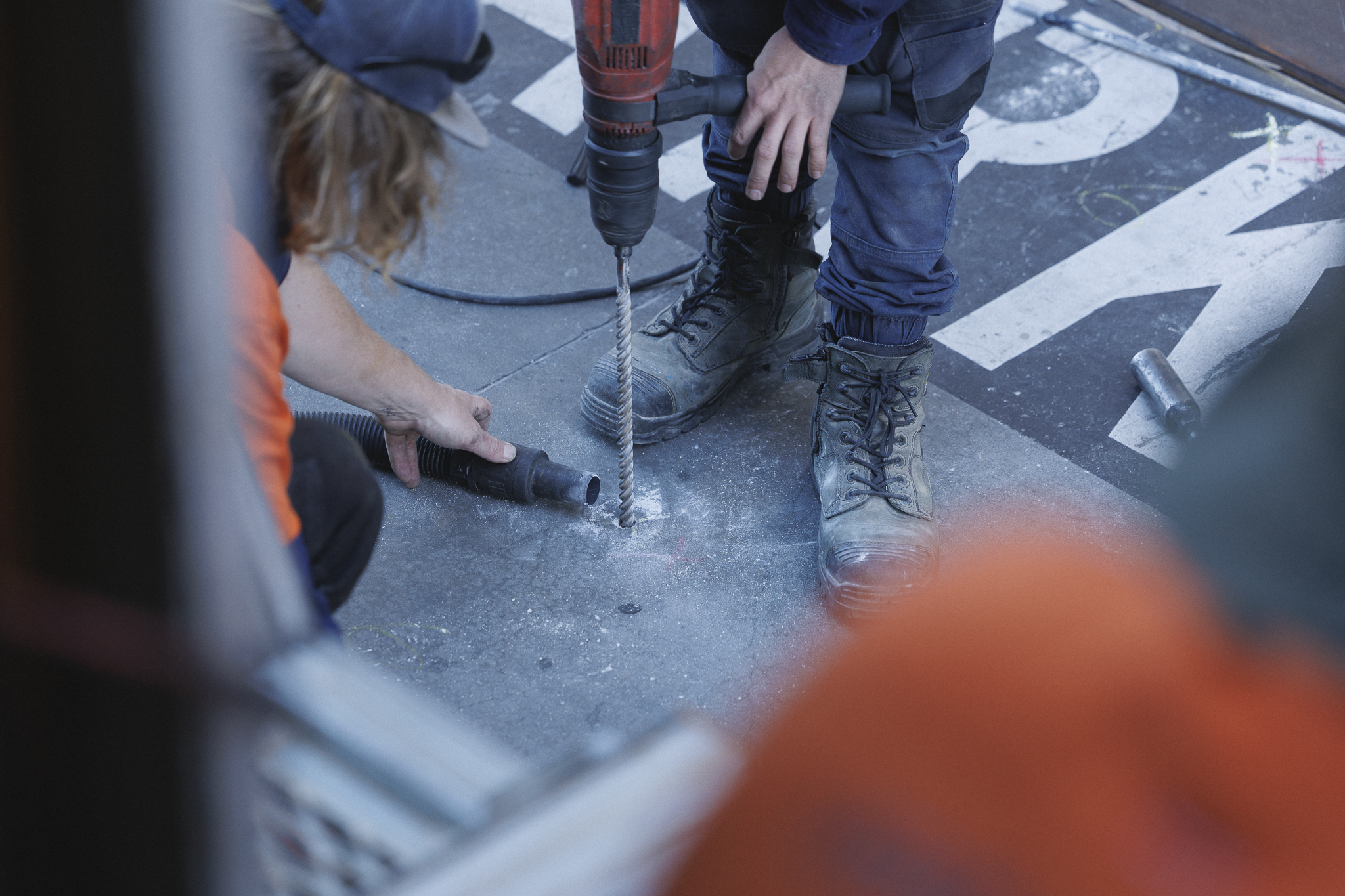

Urathane team drilling injection points

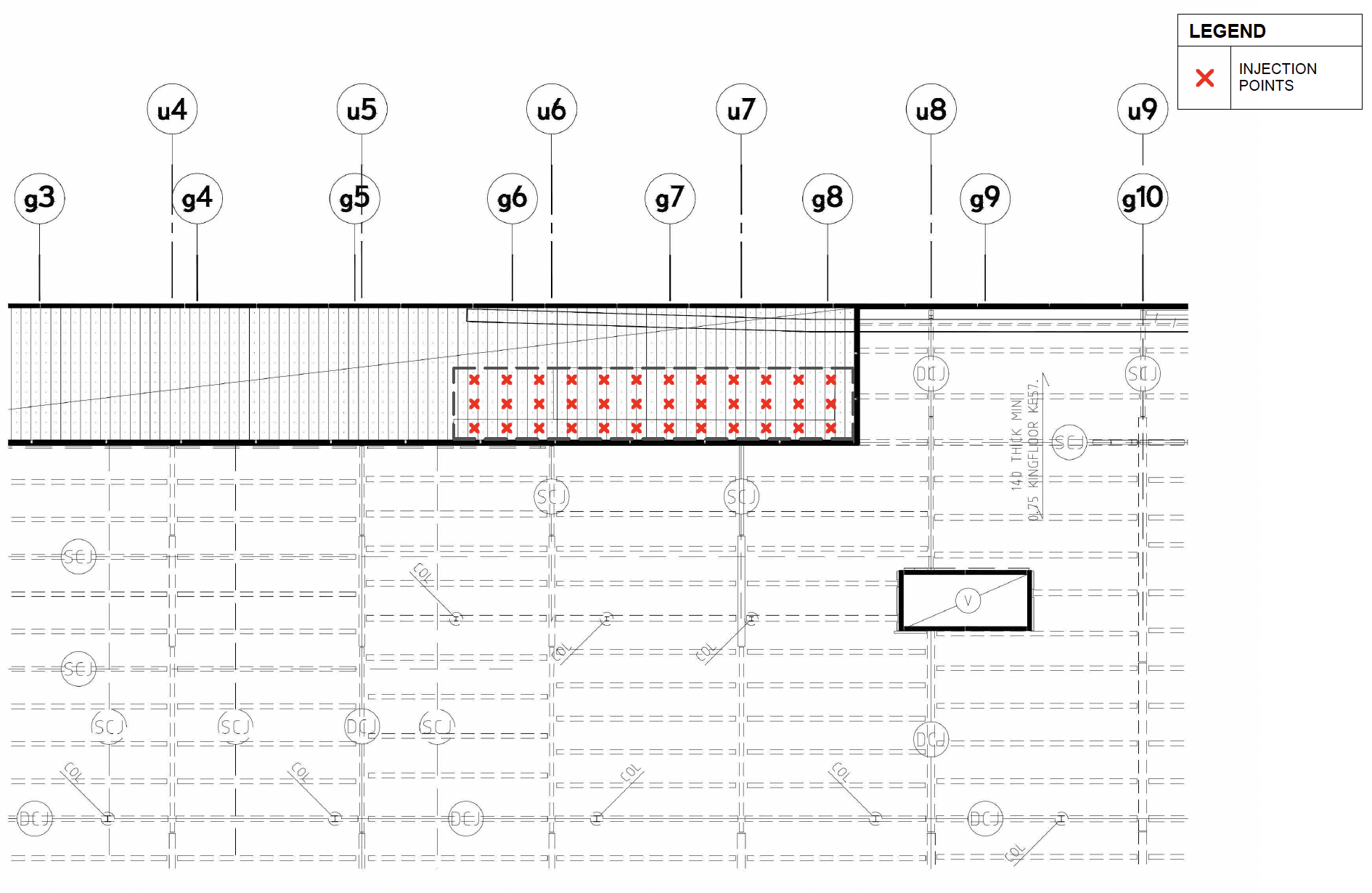

Engineered layout incorporating 95 injection points at approximately 1m depth
Click to enlarge

Execution & Delivery

To achieve optimal results, the loading dock was actively loaded with trucks and equipment during injection. This allowed greater penetration and compaction of the resin without immediate hydraulic lift, improving ground consolidation outcomes.

All works were completed within a single day (Saturday), ensuring:

  • No disruption to weekday operations
  • Immediate return to service
  • Minimal impact on deliveries and site logistics

Outcome

  • Slab stabilised and re-levelled
  • Ground conditions improved through densification
  • Temporary ramping no longer required
  • Area returned to full operational use immediately
  • Delivered within strict time constraints with zero disruption

The works enabled Bunnings to return the loading dock to full operations with just one day downtime, all while preventing much more expensive structural reworks.

Urathane Solutions truck and gear on the ramp to provide greater penetration

Have a sinking slab, loading dock or warehouse floor? Find out more about our commercial slab lifting and void filling service.

Contact us to see how we can keep your asset structurally sound.

Contact Us
Previous
Previous

Heritage Stone Footing Stabilisation & Structural Realignment – Early 1900s Property

Next
Next

Major Slab Subsidence Remediation
